Quick answer: Exhibition booth production turns a booth idea into a real space: 3D design, workshop fabrication, on-site installation and finishing before the doors open. A reliable booth builder delivers exactly what was designed, on schedule, so the brand can focus on its visitors. This article walks through each step using the booth Now Agency produced for EZVIZ at the Vietnam International Innovation Expo (VIIE).

Updated: October 2026.

Case study: the EZVIZ booth at VIIE

EventVietnam International Innovation Expo (VIIE)
VenueNational Innovation Center (NIC) Hoa Lac, Hanoi
Booth size18 m² (6 m x 3 m), ground floor
Products shownSmart locks, smart cameras
Exhibition scale100+ booths, 300+ technology companies, 50+ startups, around 40,000 visitors

The brief: in 18 m², EZVIZ needed a booth that stood out among hundreds of technology companies and let visitors try smart locks and cameras the way they would at home.

The exhibition booth production process: 5 steps

Step 1: 3D design around the brand and products

The EZVIZ booth was designed around a "smart home" idea: white walls with a roof icon, real wooden doors fitted with smart locks, display niches for cameras and a central demo counter. The 3D design carried full dimensions for client approval before production.

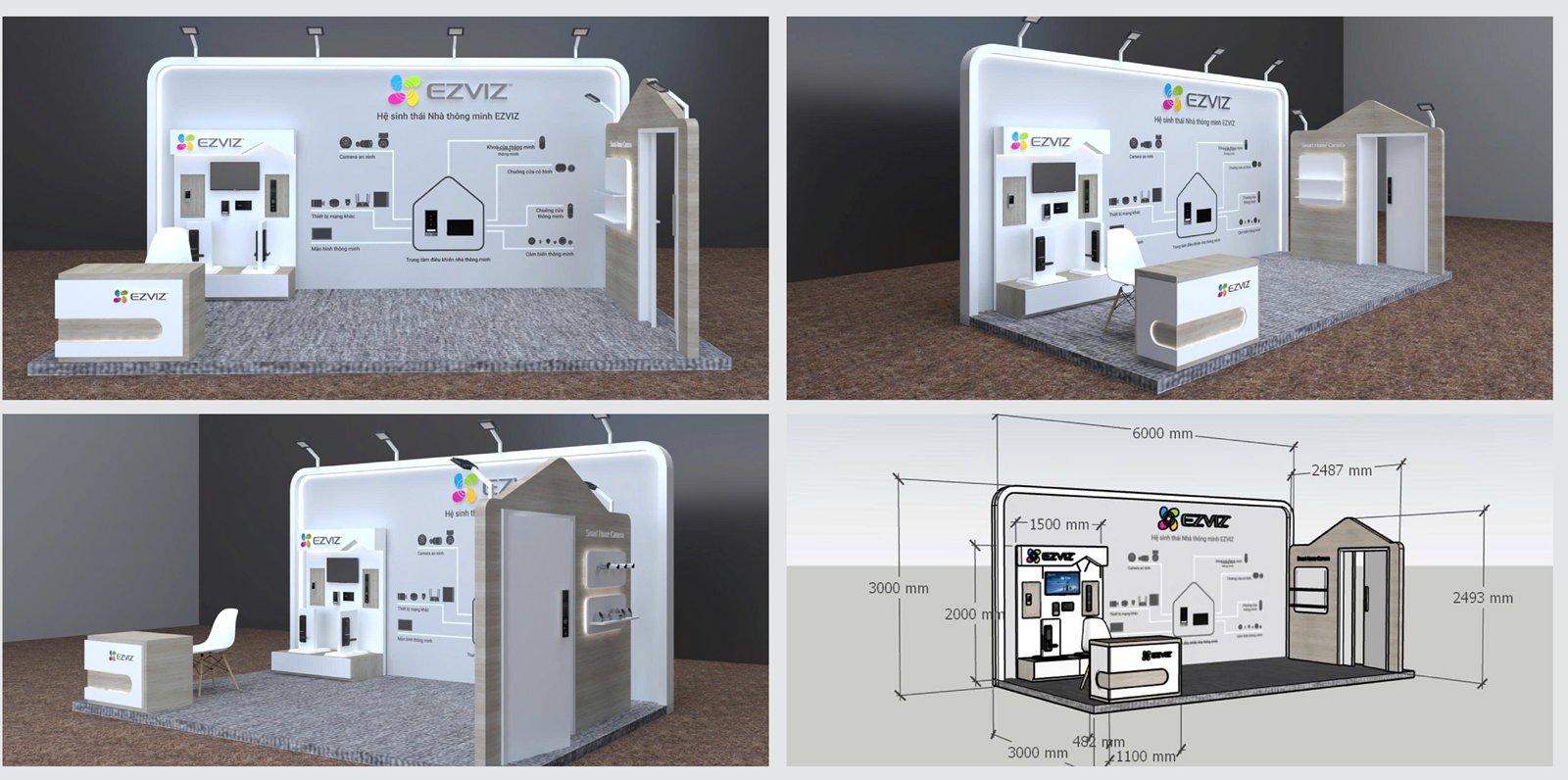

3D design of the 18 m2 EZVIZ booth with white walls, wooden doors and demo counter

Step 2: Workshop fabrication

Walls, counters and display boxes were cut, assembled and painted in the workshop. Building in advance controls surface quality and shortens installation at the venue, where time before opening is limited.

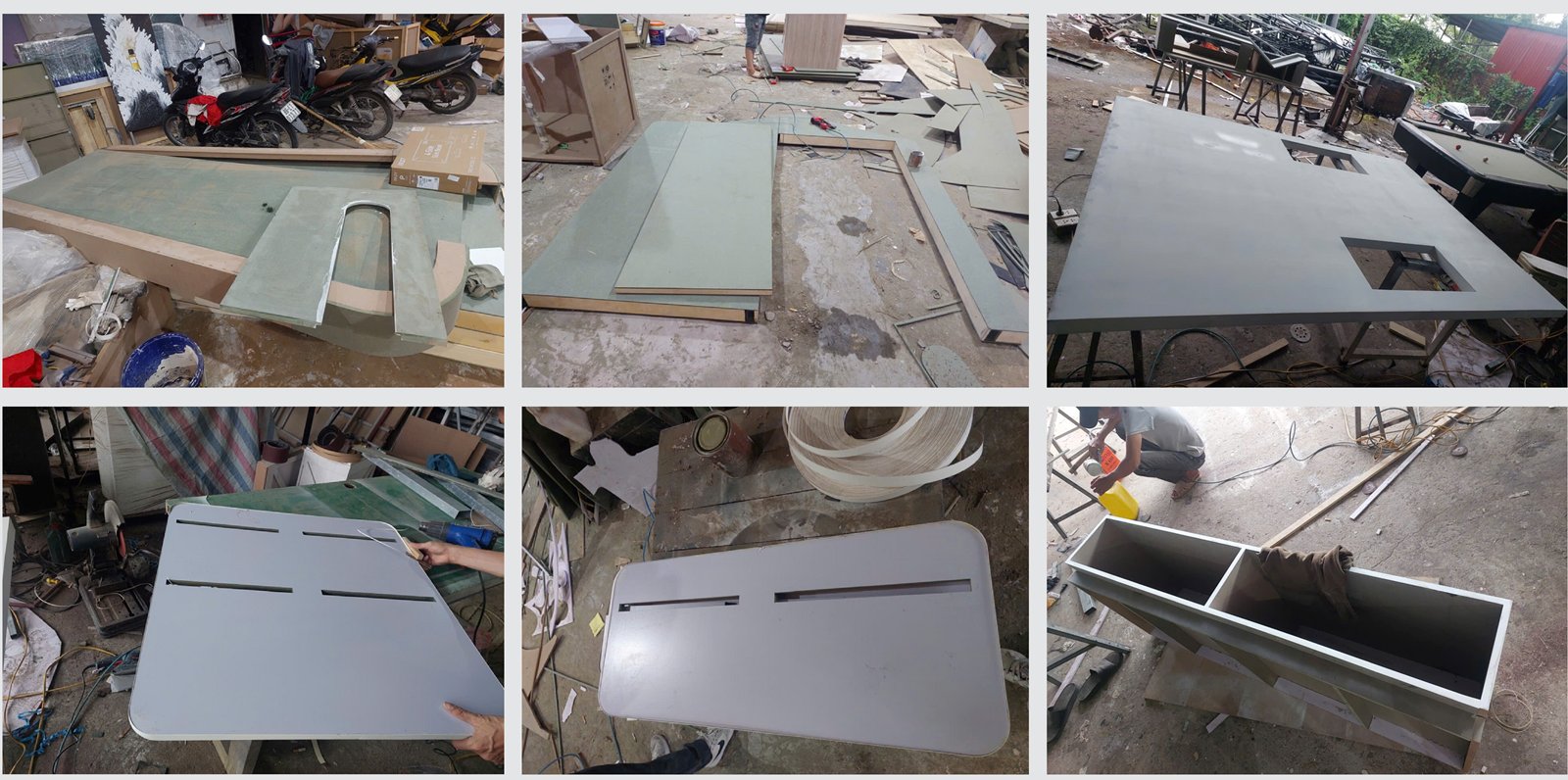

Fabricating EZVIZ booth walls and counters in the workshop before the exhibition

Step 3: On-site installation

The crew transported the components to the hall, raised the frame and fitted walls, doors and counters in the registered booth space, following the organizer's build rules.

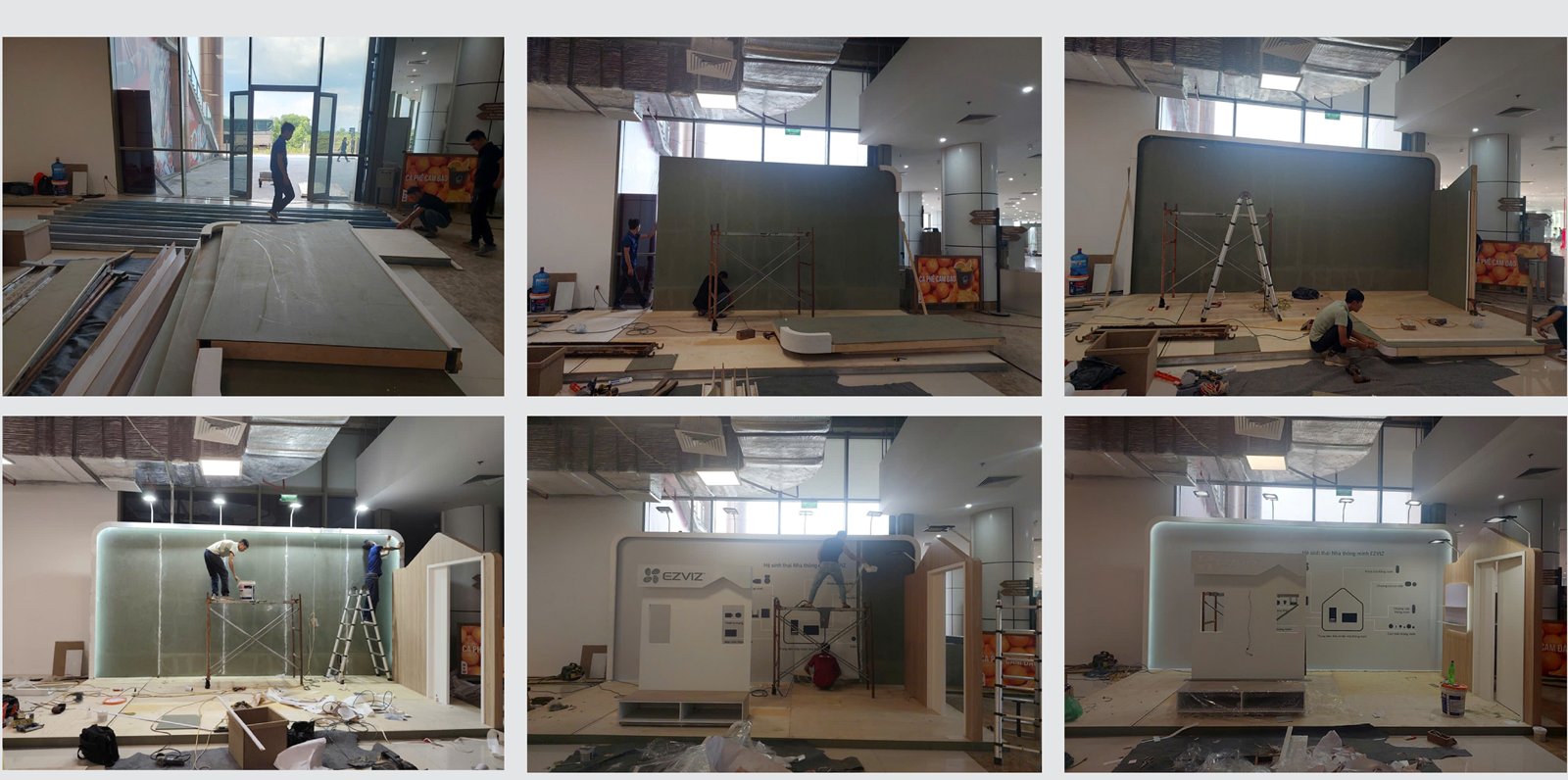

Installing the EZVIZ booth frame and walls in the exhibition hall

Step 4: Devices, lighting and products

Edge lighting, screens, locks and cameras were installed and tested on the booth. With technology products the devices must actually work for visitors to try them, so testing matters as much as building.

Step 5: Finishing, handover and operation

The booth was cleaned, checked detail by detail and handed over before opening. Over three days it drew a steady flow of visitors who unlocked doors, rang doorbells, viewed camera feeds and got advice on the spot.

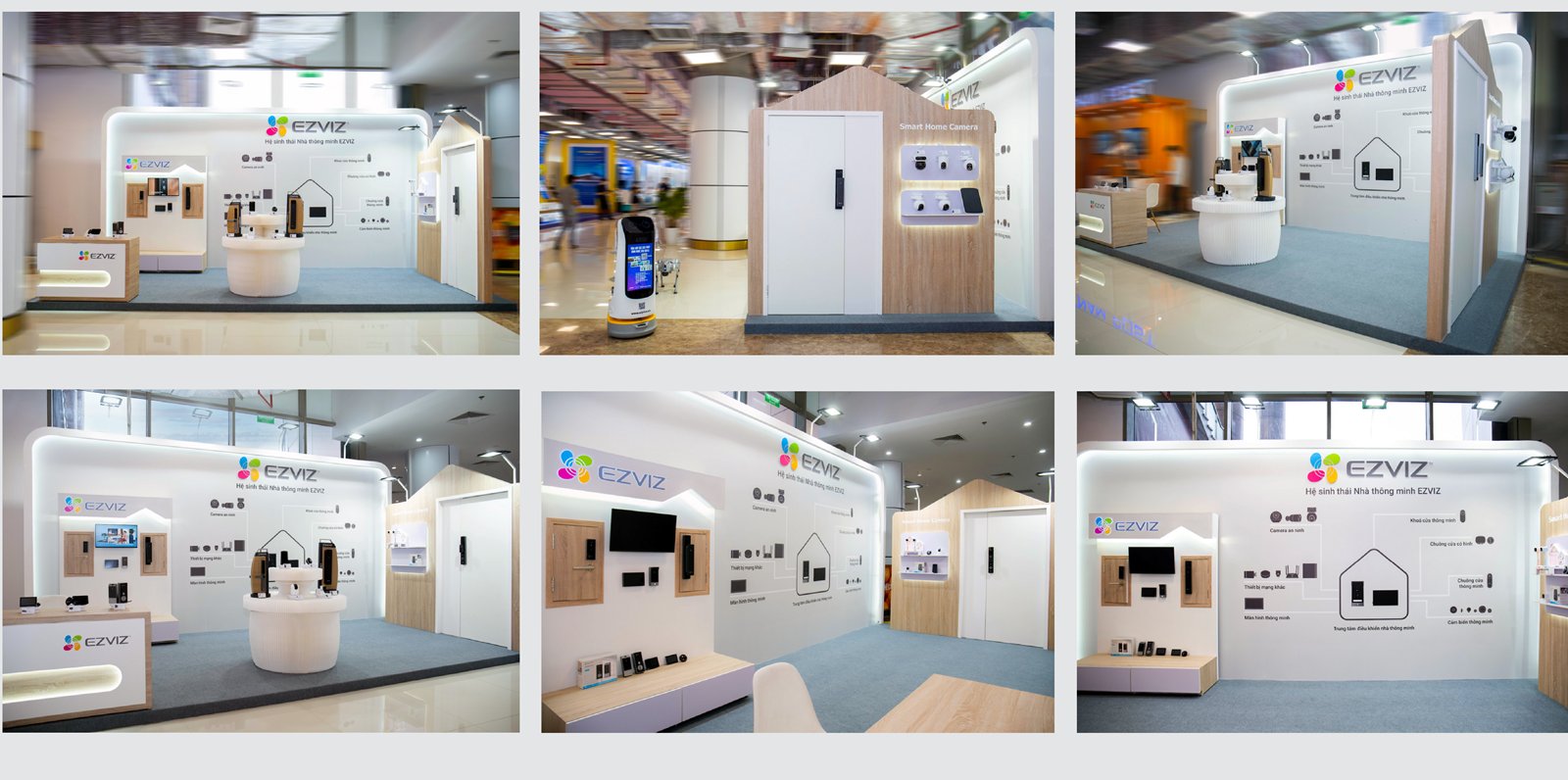

Completed EZVIZ booth at VIIE with wooden doors fitted with smart locks and a camera display counter

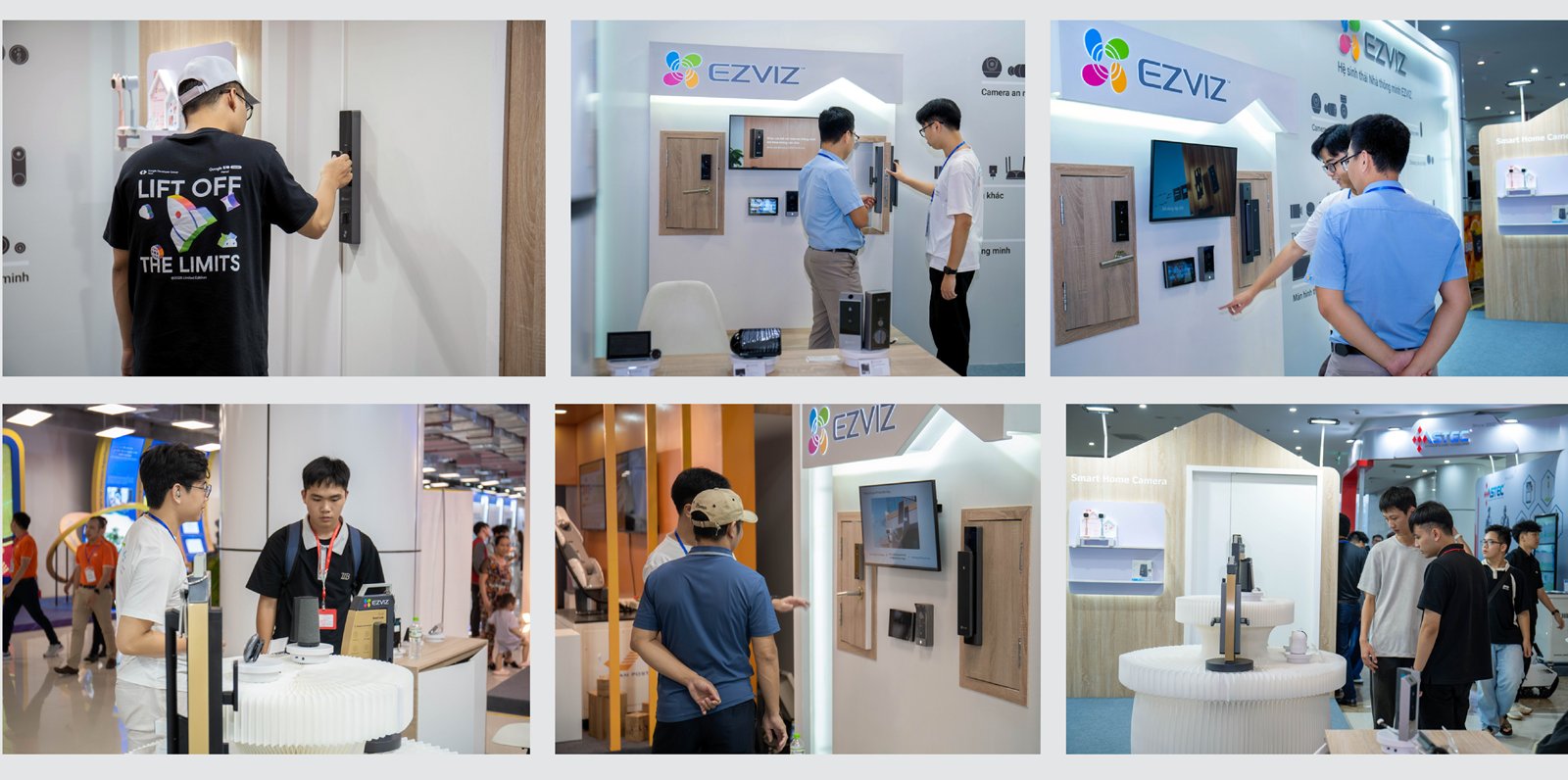

Visitors trying smart locks and cameras at the EZVIZ booth

What criteria make an exhibition booth effective?

  1. A clear objective: sales, finding distributors or brand building — each objective leads to a different design.
  2. Brand visible from a distance: a high logo, consistent colors, lighting on the main wall.
  3. An open, inviting layout: counters that do not block the aisle, displays facing the visitor.
  4. Let visitors touch the product: real doors and counters to try, not just glass cases.
  5. Products arranged by use case: an entrance zone for locks and doorbells, an indoor zone for cameras.
  6. A solid build, true to design: the real booth must match the approved 3D design, be safe and be finished before opening.
  7. Operation and communication: advisors who know the products, activations that pull visitors in and post-show content.

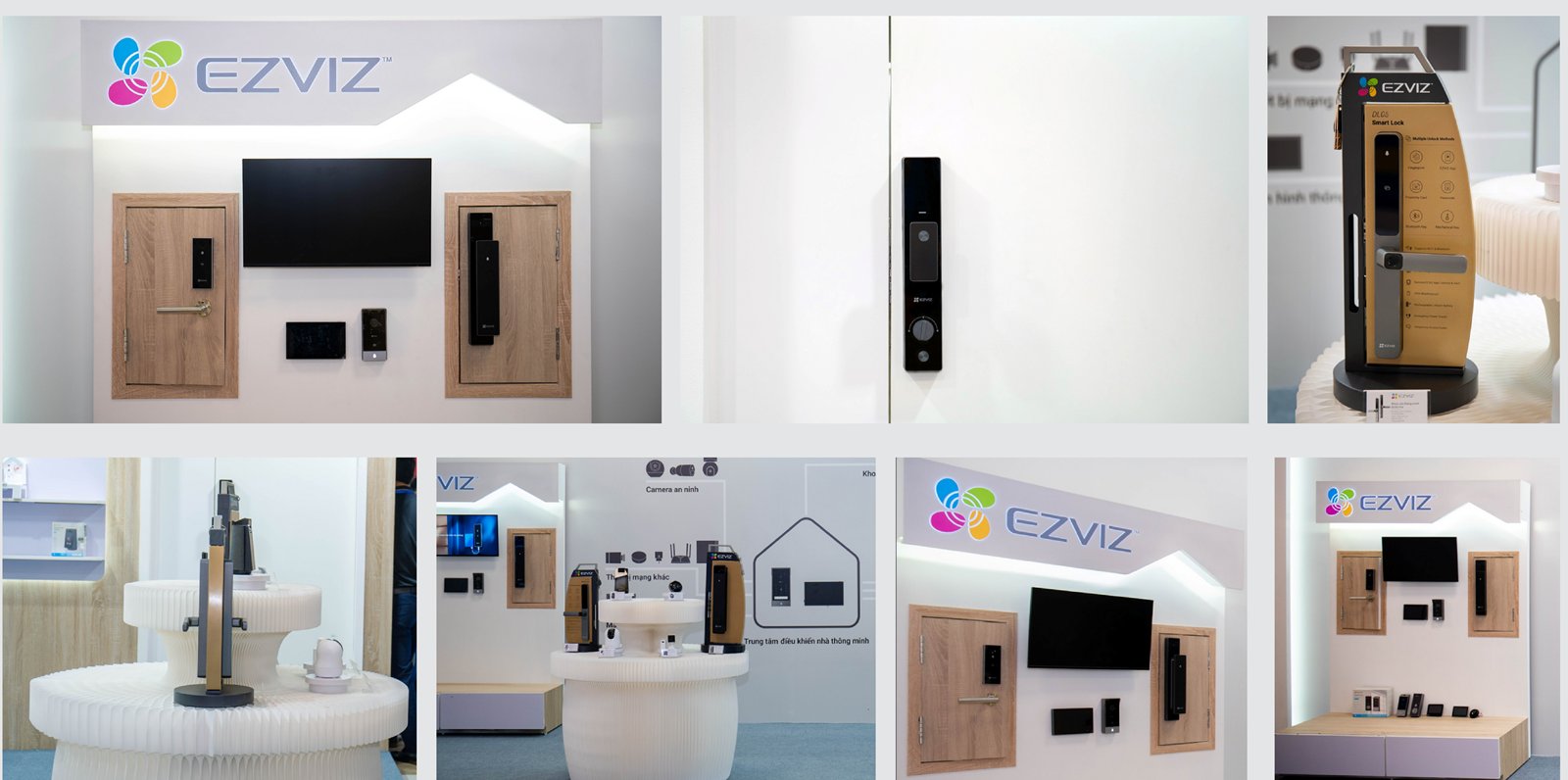

EZVIZ smart lock display zone with wooden doors and a house icon

How to choose a reliable exhibition booth builder in Vietnam

  1. Real projects to show: photos from 3D design to finished booth, not just renders.
  2. Its own workshop or a stable workshop partner: control over materials, quality and schedule.
  3. Knowledge of organizer rules: build hours, height limits, fire safety, power.
  4. A clear quotation: design, production, transport, installation and dismantling itemized.
  5. A technician on call throughout the show.

What drives booth production cost?

  • Size and position: corner and island booths need more finished sides than inline booths.
  • Materials and finish: wood, acrylic, LED lighting, screens.
  • Demo equipment: screens, real doors, demo zones.
  • Transport and installation time: especially for shows in another province.
  • Reusability: a modular design reused at later shows lowers long-term cost.

How far ahead should you prepare an exhibition booth?

For major trade shows, brands usually reserve space three to four months ahead, lock the concept about two to three months out and give the builder at least several weeks for detailed design, fabrication and testing. Alongside that runs a communication plan before, during and after the show to bring visitors to the booth.

See also how Now supported EZVIZ at VIBE and our notes on event marketing.

Frequently asked questions about exhibition booth production

What does exhibition booth production include?

3D design, workshop fabrication, transport, installation, electrical and device fitting, finishing, on-site technical support during the show and dismantling afterwards.

Is an 18 m² booth enough for technology products?

Yes, with an open layout and zones organized by use case, as with the EZVIZ booth at VIIE.

How long does booth installation take?

It depends on size and organizer rules; most components are prefabricated in the workshop to shorten on-site installation.

Can a booth be reused at later shows?

Yes, if it is designed as modules from the start.

Need a booth built for your next exhibition?

Now Agency supports you from 3D design, production and installation to booth operation and communication around the event.
